the system could not find a cost component split for AM426ANRU in plant H411.
Possible causes:
The material has not been costed.
The material has not been selected for the costing run.
The BOM was changed after the selection or BOM explosion for the costing run was carried out, and the material now has a new low-level code.
This is a configurable material and does not have a costing view in the material master.
The default value for price control is not set in the material type.
The material belongs to a recursive structure. With this material, the system begins the iterative costing of the cycle. You can check in the material overview of the cost estimate whether the material belongs to a cycle.
System Response
The material is valuated with the price determined through the valuation strategy.
Procedure
Check the log.
Carry out selection and BOM explosion for the costing run again.
If the material is a configured material, create a costing view in its master record.
If the material belongs to a cycle, the message can be ignored because only the first iterative step is affected.
Procedure for System Administration

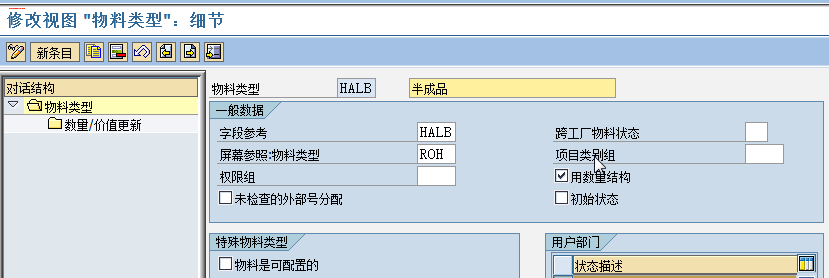

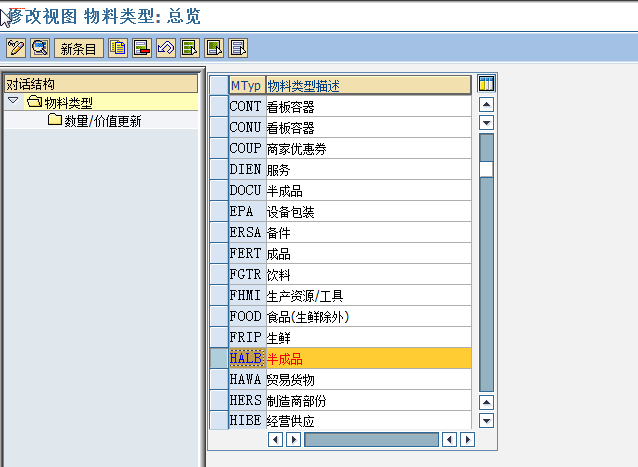

Go into Customizing for Logistics General and check the default value for price control in the material type for material AM426ANRU.
跟踪过去到了OMS2
不晓得怎么解决
上面的提示When valuating material components,
the system could not find a cost component split for AM426ANRU in plant H411,所以应该是这里分配的时候出现了问题。解决方法如下
1,你再好好分析一下这个物料的料(BOM里来),工(作业类型里来,对应提routing,在CA03里可以看到),费(可能是作业类型,也可能是费用核算单,这个得看一下你的评估变式)。
2,然后分析他们对应的成本要素。物料对应的成本要素,在OBYC里设定的。作业类型对应的成本要素,在KL03里能查到。费也在费用核算单或作业类型里能看到。
3,再看看对应的成本要素,是不是被包含在分配结构里。
